How Can Sign Shops Outsource Channel Letter Manufacturing Without Losing Control?

Sign shop outsourcing custom channel letter manufacturing to a professional sign factory

A sign shop does not need to fabricate every channel letter in-house to control the project. In many cases, the more important question is whether the shop controls the specification, approval process, installation interface, schedule, margin, and relationship with the end account. Fabrication can sit somewhere else without giving away the project. That distinction matters when a shop has a strong sales and installation team but limited bending, welding, painting, LED assembly, electrical testing, or production capacity.

Sign shops can outsource channel letter manufacturing successfully by keeping project ownership in-house while transferring fabrication to a qualified manufacturing partner. The shop should control approved drawings, materials, lighting, mounting, electrical requirements, delivery dates, and communication rules, while the factory handles engineering review, production, testing, packaging, and documented handoff for installation.

The model is becoming increasingly practical rather than unusual. Current wholesale-sign search results openly describe hybrid production, where routine work stays inside the sign shop while complex, certified, high-volume, or overflow jobs go to a specialist manufacturer. The real risk, then, is not outsourcing itself. The risk is outsourcing a poorly defined project to a factory that cannot preserve the shop’s standards. A channel letter set may look simple in an elevation drawing, yet one wrong wire exit, return depth, mounting pattern, paint color, LED layout, or power configuration can turn a profitable order into an expensive installation-day problem.

When Should Sign Shops Outsource Channel Letters?

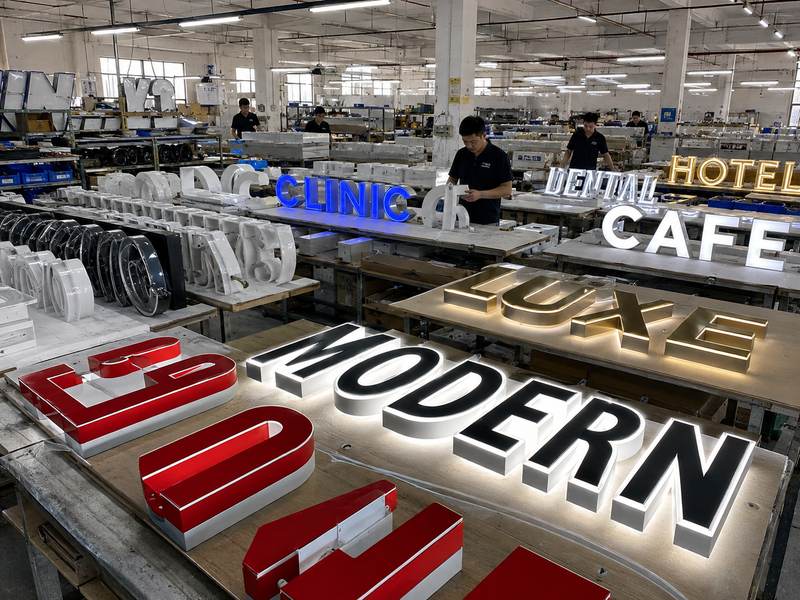

Channel letter manufacturing capacity for sign shops outsourcing overflow and complex projects

Sign shops should outsource channel letters when internal fabrication becomes the bottleneck—because of a full production schedule, missing equipment, complex fabrication, large repeat orders, or fixed installation dates. The strongest outsourcing candidates are projects where external production protects delivery dates and installation capacity without giving up control of drawings, specifications, pricing, project communication, or the end-account relationship.

What Types of Projects Are Better Outsourced?

Not every channel letter order belongs in an outside factory. A shop that already has an experienced fabrication crew, available equipment, and an open production schedule may produce standard front-lit letters efficiently in-house. Outsourcing becomes more useful when a project begins consuming resources outside the shop’s normal production rhythm.

The first sign is usually capacity pressure. Suppose a shop normally completes 8–12 channel letter sets per month and already has most of the coming three weeks scheduled. A new 15-store rollout may be profitable, but accepting it entirely in-house could push existing jobs behind their promised installation dates. Sending part or all of the rollout to a manufacturing partner can protect both orders.

Projects commonly suited to outsourcing include:

  • Large quantities that would occupy normal production for several weeks
  • Multi-location rollouts requiring the same construction across many sets
  • Rush projects arriving when bending, welding, painting, or assembly stations are already full
  • Halo-lit and front-and-halo-lit letters requiring tighter control of depth, stand-off distance, LED placement, and rear illumination
  • Complex logos with narrow strokes, small internal spaces, sharp corners, or irregular shapes
  • Stainless steel letters or special metal finishes outside the shop’s usual work
  • Large letters that need segmentation for fabrication, packing, or shipping
  • Outdoor sets requiring coordinated drainage, sealing, wiring, and corrosion considerations
  • Projects requiring specific voltage, power supply, or certification arrangements
  • Orders that need installation-ready packing for several locations

Channel letters involve more than forming metal returns. Their performance depends on font and logo engineering, face and back construction, LED layout, power matching, wiring, weather protection, drainage, mounting preparation, testing, and packaging.

A project may also be worth outsourcing even when the shop technically can make it. Capability and economic efficiency are not the same thing.

For example, a shop may be able to fabricate a complex stainless halo-lit logo, but completing it may require:

  • 6–10 hours of extra engineering and drawing adjustment
  • several welding and grinding operations
  • a special paint or metal finish
  • a trial LED layout
  • additional testing before installation
  • dedicated packing because of polished surfaces

If similar work appears only a few times each year, developing and maintaining the process internally may produce little return.

A practical screening table can help:

Project SituationIn-House FitOutsourcing Fit
Standard front-lit letters, familiar constructionHighMedium
Production schedule already near capacityLowHigh
20+ repeated setsMediumHigh
Complex halo-lit logoMediumHigh
Unusual stainless finishLow–MediumHigh
One simple replacement letterHighLow
Multi-store opening scheduleMediumHigh
Large letters needing special packingMediumHigh
Project requiring unfamiliar electrical setupLowHigh

The important question is not simply, “Can we manufacture it?”

The better question is:

“Can we manufacture it without disrupting more profitable or time-sensitive work already moving through the shop?”

Is Outsourcing Better Than In-House Production?

Outsourcing is not automatically better than in-house manufacturing. The right choice depends on total project cost, available capacity, production difficulty, lead time, and how much risk the shop is willing to carry internally.

A common mistake is comparing only two numbers:

Internal material cost vs. factory quotation.

That comparison ignores a large part of the real cost.

In-house production can include:

  • design and engineering hours
  • operator labor
  • bending-machine time
  • CNC or router time
  • welding and grinding
  • paint preparation and finishing
  • LED installation
  • wiring
  • power supply preparation
  • testing space
  • quality inspection
  • rework
  • packaging
  • supervision
  • production floor occupancy

Consider an illustrative project involving ten channel letter sets.

If internal fabrication saves $180 per set compared with an outsourced quotation, the apparent saving is $1,800.

But assume completing those ten sets also creates:

  • 45 additional fabrication hours
  • 18 hours of finishing work
  • 15 hours of LED assembly and wiring
  • 10 hours of QC and rework
  • several days of occupied production space

If the same employees and equipment could have been used for other profitable projects, part of the $1,800 “saving” is no longer real.

The comparison should therefore look more like:

Cost AreaIn-HouseOutsourced
MaterialsShop purchasesIncluded in factory price
Skilled fabrication laborInternalIncluded
Machine utilizationInternalExternal
Engineering timeUsually internalPartially external
QC laborInternalFactory QC + receiving check
Rework exposureShop carries mostShared according to cause
FreightUsually lower locallyMust be calculated
Production capacity usedHighLow
Installation resourcesStill requiredStill required
Schedule flexibilityDepends on queueCan increase

In-house production usually makes sense when the shop has:

  • the correct equipment already installed
  • experienced employees
  • stable material supply
  • predictable construction
  • enough production time before installation
  • recurring volume that keeps equipment productive

Outsourcing becomes more attractive when one or more of those conditions disappear.

A shop does not have to make a permanent decision either. A project that belongs in-house in February may need to be outsourced in September if the production schedule is full.

The decision should be made at project level rather than becoming an ideological choice between “we manufacture everything” and “we outsource everything.”

How Can Outsourcing Solve Capacity Gaps?

Capacity problems usually appear before equipment physically reaches its maximum output.

The first warning signs are operational:

  • quotations are still increasing but fabrication lead times are getting longer
  • installation teams are waiting for products
  • overtime becomes routine
  • samples and small jobs are constantly pushed behind larger orders
  • one difficult project occupies a workstation for several days
  • production managers begin moving jobs around every morning
  • rush orders require delaying work that was already approved
  • sales staff hesitate to accept new projects because the shop is full

At that point, outsourcing can act as temporary production capacity.

Iduoduo’s documented manufacturing system includes five production bases, 18 production lines, more than 500 employees, and regular monthly output of approximately 15,000 units, depending on product type, size, structure, lighting, packaging, and scheduling. The company also documents additional flexible capacity depending on order mix and production planning.
For a sign shop, however, a factory’s headline capacity number is only the starting point.

Before assigning a large order, confirm:

  • how many sets can enter production during the required period
  • whether the same construction can run in parallel
  • whether special materials are already available
  • when approved drawings must be released
  • whether a first article is required
  • how long QC and testing will take
  • whether the order will ship together or in batches
  • whether packing needs to be organized by location

A simple capacity example shows why the arrangement can work.

Imagine a shop normally handles:

Work TypeMonthly Volume
Standard channel letter sets10
Small replacement jobs6
Cabinet or light box projects4
Installation projects15–20

Now a 25-location rollout arrives.

Manufacturing all 25 sets internally could force the shop to delay regular work for several weeks. Outsourcing the rollout—or even 15 of the 25 sets—allows the shop to preserve production space for everyday orders while keeping its installation calendar moving.

Capacity outsourcing is especially valuable when demand is temporary.

Hiring three additional fabricators for a two-month spike can leave excess payroll afterward. Buying another machine for one large rollout may leave the machine underused for the rest of the year.

External manufacturing changes part of the production cost from fixed overhead into project-based cost.

That flexibility is often more valuable than achieving the absolute lowest fabrication cost on every individual set.

Which Jobs Fit a Hybrid Manufacturing Model?

A hybrid manufacturing model allows a sign shop to keep the work it performs efficiently and outsource the work that creates bottlenecks, unfamiliar risks, or excessive production load.

In practice, the model can be simple.

Keep standard local work in-house. Send overflow production, specialist fabrication, or large repeat orders to an outside manufacturer.

For example:

Job TypePossible Production Decision
Standard front-lit set for a local storeIn-house
Replacement letter for an existing installationIn-house
30 identical storefront setsOutsource
Complex stainless halo-lit logoOutsource
Rush project during a full production weekOutsource
Normal project during a quiet periodIn-house
Large national rolloutOutsource or split production
Specialty finish not normally producedOutsource
Prototype requiring frequent local changesOften in-house
Approved repeat designStrong outsourcing candidate

The strongest hybrid systems use clear rules rather than deciding only when the shop is already overloaded.

A shop might decide, for example:

  • Projects under five standard sets stay in-house when production capacity is available.
  • Orders above 20 repeated sets are automatically reviewed for outsourcing.
  • Specialty halo-lit work is outsourced unless the construction matches an established internal standard.
  • Jobs that would push an installation date beyond the promised deadline are reviewed for external production immediately.
  • Multi-location programs are evaluated based on combined fabrication, packing, labeling, and rollout requirements rather than unit price alone.

Those numbers are examples rather than universal rules. Every shop should set thresholds around its own equipment, labor, margins, and normal workload.

The hybrid approach also lets the shop keep the most valuable parts of the project under its own control.

The local team can remain responsible for:

  • site survey
  • permit coordination
  • account communication
  • final specification
  • drawing approval
  • selling price
  • local delivery planning
  • installation
  • service

The manufacturing partner can handle:

  • production-file review
  • manufacturability checks
  • metal fabrication
  • acrylic fabrication
  • LED layout
  • wiring
  • QC
  • testing
  • packaging
  • repeat-production records

Iduoduo’s documented sign-company model follows that division. The factory can provide OEM production, samples, peak-season manufacturing support, special processes, QC, testing, export packaging, and repeat-order file retention without taking over the sign company’s end-account relationship.

The financial effect can be larger than the fabrication margin on a single project.

Consider a 40-location restaurant rollout. Keeping every set in-house may preserve more manufacturing margin per unit. But if the rollout occupies bending, welding, painting, assembly, and testing capacity for six weeks, several smaller local projects may be delayed or rejected.

The more useful calculation is:

Gross profit from manufacturing the rollout internally

versus

Gross profit from the rollout after outsourcing + profit from all other work the shop can continue accepting during the same period.

For many established sign shops, outsourcing becomes valuable at exactly that point. The factory is not replacing the sign shop. It is removing the manufacturing bottleneck that prevents the shop from taking on more profitable work.

What Should You Send for an Accurate Quote?

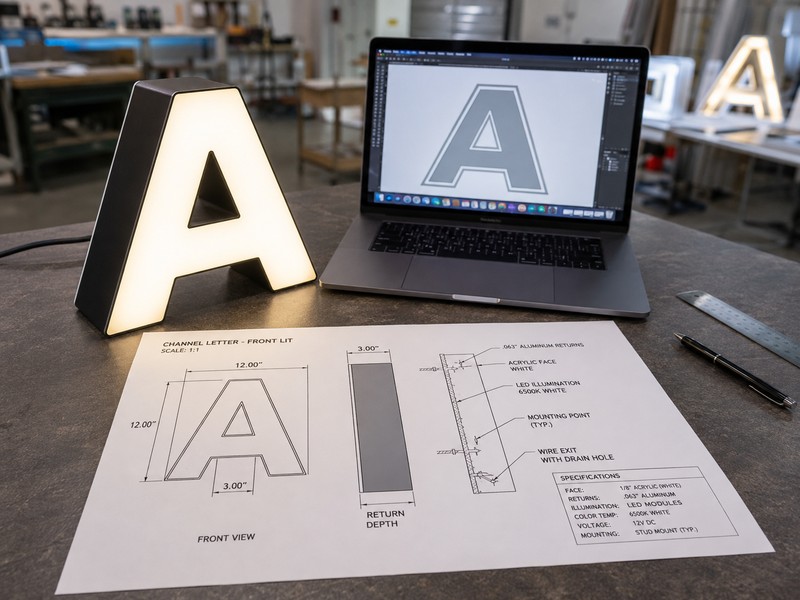

Channel letter shop drawing and specifications prepared for an accurate manufacturing quote

For an accurate channel letter quote, send enough information to define the sign before pricing starts: vector artwork, dimensions, quantity, illumination, materials, colors, return depth, voltage, mounting, wire exits, indoor or outdoor use, certification requirements, destination, packaging, and required delivery date. Complete specifications reduce provisional pricing, repeated revisions, engineering changes, and unexpected costs after approval.

Which Artwork and Drawings Are Needed?

A logo file alone is often enough for an initial discussion, but it is rarely enough for a production-ready quotation. The manufacturer needs to understand not only what the sign should look like, but also its actual dimensions, construction, wall relationship, wiring, and installation interface.

For established sign shops, the most useful starting package normally includes:

  • Vector logo: AI, EPS, SVG, or vector PDF
  • Shop drawing
  • Elevation drawing
  • Section drawing when depth or mounting needs explanation
  • CAD drawing when mounting positions or architectural dimensions matter
  • Storefront or wall photo
  • Wall dimensions
  • Existing sign dimensions when replacing an old sign
  • Brand guidelines when Pantone colors, fonts, or proportions are controlled

Iduoduo’s documented RFQ process specifically accepts shop drawings, elevation drawings, section drawings, vector artwork, overall dimensions, letter height, return depth, mounting details, wire exits, and other project information.

The most important point is scale.

A manufacturer cannot reliably quote from a logo marked only “120 inches wide” if the artwork contains several letters with very different stroke widths. Two logos with the same overall width may require completely different fabrication.

For example:

Design DetailWhy the Factory Needs It
Overall widthEstablishes project scale
Letter heightHelps estimate individual letter construction
Minimum stroke widthDetermines whether LED modules and internal structure fit
Return depthAffects metal usage, lighting space, weight, and appearance
Logo spacingInfluences mounting pattern and installation
Section detailClarifies wall, stand-off, raceway, or backboard relationship
Wall photoHelps identify practical mounting and wiring conditions

A JPG or screenshot can be useful for reference, but it should not automatically become the manufacturing master file. Low-resolution artwork can hide curves, small gaps, incorrect fonts, and narrow sections.

When no production drawing exists, provide the vector artwork, required overall size, wall condition, lighting style, and installation method first. An engineering team can then determine what additional information is required before quotation or production.

What Product Specs Should Be Confirmed?

Channel letter pricing changes significantly when construction changes, so the quotation should define the product more precisely than “LED channel letters, 1,500 mm wide.”

Iduoduo’s documented channel letter RFQ list contains twenty practical inputs: logo or font file, overall size, letter height, quantity, lighting method, face color, return color, return depth, indoor or outdoor location, LED color or CCT, voltage, power-supply certification, mounting method, raceway or backboard, wire exit, wall condition, waterproof requirement, destination country, packaging, and project date.

A useful specification sheet can be organized like this:

SpecificationExample
Overall size2,400 × 650 mm
Quantity12 sets
LightingFront-lit
FaceWhite acrylic
ReturnAluminum
Return depth80 mm
FinishMatte black
LED6500K white
LocationOutdoor
Input voltage120V
MountingIndividual letters with studs
Wire exitRear center of each letter
Power supplyRemote mounted
DestinationDallas, Texas, USA
Required arrivalOctober 20

Small specification changes can alter cost more than expected.

A 50 mm-deep letter and a 120 mm-deep letter do not use the same amount of metal. A simple front-lit construction does not have the same manufacturing steps as a front-and-halo-lit letter. Stainless steel, aluminum, painted finishes, polished surfaces, and specialty coatings require different fabrication and finishing processes.

Lighting details also matter. “White LED” is not precise enough when a brand expects a particular appearance. Warm white, neutral white, and cool white create visibly different results. Iduoduo’s documented lighting options include different color temperatures, single colors, RGB, RGBW, dimming, and project-specific control arrangements.

Before asking several factories to compare prices, send the same specification to each one. Otherwise, a lower quotation may simply represent a different construction rather than a lower price for the same sign.

How Do Mounting and Wiring Details Affect Production?

Mounting and wiring information should be confirmed before fabrication because both affect the physical construction of the letters. Leaving them until installation can create unnecessary drilling, rewiring, adapters, visible cables, or site modifications.

For mounting, confirm at least:

  • Individual letter mounting or raceway mounting
  • Backboard required or not
  • Stud size and position
  • Mounting-hole pattern
  • Wall material
  • Stand-off distance
  • Installation template requirement
  • Access behind the wall
  • Whether installers need numbered letters
  • Required mounting hardware

Wall material is especially important.

Concrete, brick, metal cladding, wood, glass, ACM panels, and interior drywall do not create the same installation conditions. The manufacturer does not need to replace the local installer or structural engineer, but it does need enough information to manufacture the agreed installation interface.

For wiring, confirm:

  • Input voltage
  • LED voltage where applicable
  • Power-supply position
  • Remote or integrated power supply
  • Cable exit location
  • Cable exit direction
  • Cable length requirement
  • Number of circuits or wiring groups
  • Controller requirements for RGB or RGBW
  • Whether power supplies should be packed separately

Iduoduo’s documented engineering scope includes power capacity, wiring groups, wire exits, mounting holes, backboards, raceways, stand-off structures, waterproofing, drainage, and installation methods.

A simple example shows why these details matter.

Suppose the drawing shows a 2-meter-wide front-lit logo on an ACM storefront. The factory assumes rear-center wire exits, but the installer has electrical access only through the lower-right area. If the mismatch is discovered on installation day, the crew may need to reopen letters, extend wiring, drill additional penetrations, or make visible cable runs.

An inexpensive correction inside the factory can become an expensive correction on a lift.

Mounting templates are equally important. Hole positions should correspond to the approved production file, not to an earlier drawing version. A sign shop planning installation around a template should therefore treat the template as part of the manufactured product, not as an optional piece of paper added at the end.

Do Voltage and Certification Requirements Matter?

Voltage and certification requirements matter because channel letters contain electrical components, and destination markets do not use identical electrical systems or project requirements.

A factory should know the destination country before selecting power supplies or finalizing the electrical configuration.

Iduoduo’s documented international-project process requires project-specific confirmation of input voltage, plug type, power-supply certification, electrical requirements, mounting method, packaging, logistics, local permitting conditions, and outdoor environment.

Typical information to provide includes:

Electrical ItemWhat to Confirm
Destination countryUSA, Canada, UK, EU, Australia, etc.
Input voltage110V, 120V, 220V, 230V, or project requirement
Power supplyRequired type and installation location
CertificationRequired certification for the specific project
PlugOnly where plug-connected equipment is applicable
LED color/CCTRequired visual output
ControllerRGB/RGBW/dimming when applicable
Outdoor useWaterproof and drainage considerations

Do not assume that asking for “UL channel letters” or “CE signs” automatically defines every requirement.

The local sign company remains responsible for confirming what the project, authority having jurisdiction, permit documentation, electrician, landlord, or installation contractor requires. The manufacturer’s role is to understand those requirements early enough to select and build the requested product configuration.

The same applies to outdoor ratings.

A coastal exterior wall, an indoor shopping mall, a covered storefront, and an exposed rooftop installation do not need identical protection. The factory should know the real environment rather than automatically adding the highest possible specification to every quotation.

Providing electrical and certification requirements during RFQ prevents a common problem: receiving an attractive initial price and later discovering that the quoted power supply or construction does not meet the project’s actual requirement.

What Shipping Information Should Be Provided?

Shipping information should be included during quotation because freight is strongly affected by product size, packaging volume, weight, destination, delivery method, and project deadline.

For international channel letter orders, provide:

  • Destination country
  • City and postal code
  • Commercial or residential delivery address
  • Quantity
  • Required arrival date
  • Whether the shipment goes to the sign shop or directly to the job site
  • Whether the order can ship in batches
  • Whether each store requires separate packaging
  • Whether oversized products may be segmented
  • Any carton-labeling requirements
  • Whether accessories need to be packed by store or sign set

Production time and shipping time should always be treated separately.

Iduoduo’s documented reference transit times are approximately:

Shipping MethodReference Transit
ExpressAbout 12 days
Sea freight to USAAbout 30 days
Sea freight to EuropeAbout 50–60 days

Actual transit can change because of flight or vessel schedules, customs clearance, ports, peak seasons, weather, and local delivery.

Production should therefore not be scheduled backward from the installation date using factory lead time alone.

For example, if a project must be installed on November 15, planning should include:

  • drawing and specification approval
  • material preparation
  • production
  • QC
  • 72-hour pre-shipment testing
  • packing
  • international transport
  • customs clearance
  • local delivery
  • receiving inspection
  • installation scheduling

A product completed in the factory on November 5 is not useful if the installer needs it on November 8 and international transit takes several weeks.

Packaging requirements also affect price. Small letters may ship efficiently in reinforced cartons with EPE protection. Large or fragile assemblies may require stronger protection. Iduoduo’s documented packaging system includes individual protection, reinforced cartons, EPE foam, corner protection, separately packed power supplies and installation accessories, and stronger structures for large products where required.

For multi-location programs, add store identification before production is released.

A typical carton mark can contain:

  • Project number
  • Store number
  • Location
  • Sign type
  • Carton number, such as 1 of 4
  • Product number
  • Installation hardware identification

A factory producing 30 identical-looking sets can manufacture them correctly and still create a serious field problem if power supplies, templates, hardware, or letters are mixed between locations.

An accurate quotation therefore needs more than enough information to calculate the sign. It needs enough information to understand how the finished sign will leave the factory, reach the correct location, and enter the installer’s hands ready for the next step.

How Does the Outsourcing Process Work?

Channel letter outsourcing process from approved drawing to factory production

Channel letter outsourcing should move through clear control points: file review, quotation, drawing approval, sample or first-article confirmation when needed, production, QC, testing, packing, and shipment. The sign shop should always know which drawing version is being manufactured, which specifications are approved, and when changes stop being free revisions and begin affecting cost or lead time.

How Are Files Reviewed Before Production?

The first factory review should happen before a quotation becomes a production order. A logo may look complete on screen but still contain several details that affect whether the letters can be manufactured, illuminated evenly, packed safely, and installed without field modification.

The review normally starts with the artwork and the project specifications. Iduoduo’s documented process accepts AI, PDF, SVG, CAD, shop drawings, elevation drawings, section drawings, storefront photos, and other project files. For channel letters, the review should cover overall dimensions, individual letter height, return depth, face and return materials, illumination, mounting, wire exits, voltage, power-supply requirements, certification, wall condition, destination, packaging, and delivery date.

The engineering team should then check whether the visual design works as a physical sign.

Typical questions include:

  • Are any strokes too narrow for the planned LED modules?
  • Are internal corners too tight for clean metal forming?
  • Is the return depth sufficient for the selected illumination?
  • Can the acrylic face be manufactured without weak sections?
  • Is there enough internal space for LED modules and wiring?
  • Will the letter remain flat at the proposed size?
  • Does the mounting arrangement match the wall?
  • Are wire exits positioned where the installer can actually use them?
  • Does a large logo need segmentation for production or transport?
  • Does an outdoor set need drainage or additional weather protection?
  • Will the finished package exceed practical freight dimensions?

Iduoduo’s engineering scope includes material combinations, return depth, plate thickness, LED layout, power capacity, wiring groups, wire exits, mounting holes, backboards, raceways, waterproof construction, drainage, large-product segmentation, packaging loads, transportation dimensions, and installation methods.

A practical file review can be divided into four stages:

Review AreaWhat Is CheckedCommon Problem Found
ArtworkFont, logo shape, minimum strokesNarrow strokes cannot hold the intended LEDs
StructureDepth, metal, face, backLetter is too shallow or too large
ElectricalLED, voltage, power, wiringWrong power configuration for destination
InstallationStuds, holes, wire exits, racewayFactory drawing does not match the wall

One of the most expensive mistakes is allowing the factory to “make it work” without recording the changes.

Suppose a sign shop sends a 3,000 mm-wide logo with very narrow strokes. The factory decides to increase several strokes by 4 mm so LED modules will fit. Manufacturing may become easier, but the brand geometry has changed. If the revision is not returned for approval, the problem may not be noticed until the sign reaches the job site.

The safer process is simple: identify the conflict, propose the adjustment, show the revised drawing, obtain written approval, and only then release production.

The goal of file review is not to slow down the order. It is to discover inexpensive problems while they are still drawings rather than expensive problems after they become metal, acrylic, paint, LEDs, freight, and installation labor.

What Should Be Approved Before Manufacturing?

Production should start from one final approved version.

A common source of errors is not poor fabrication; it is unclear approval. The shop may confirm the size in email, change the color in WhatsApp, approve a new mounting pattern in a PDF, and later send another logo file with a different letter spacing. If those changes are not consolidated, different departments can end up working from different information.

Before production is released, the approved file should clearly define:

  • Final logo or font
  • Overall dimensions
  • Individual letter dimensions where necessary
  • Face material
  • Return material
  • Back material
  • Return depth
  • Surface finish
  • Face color
  • Return color
  • Illumination type
  • LED color or CCT
  • Voltage
  • Power-supply arrangement
  • Mounting method
  • Stud or hole pattern
  • Wire exit positions
  • Raceway or backboard details
  • Indoor or outdoor use
  • Waterproof requirements
  • Quantity
  • Packaging method
  • Destination
  • Required delivery date

The approved version should have a visible drawing number, revision number, or approval date.

For example:

DocumentExample
Project No.CL-260815-07
DrawingCL-260815-07-R3
RevisionR3
Approval DateAug. 15
Quantity18 sets
StatusApproved for Production

The exact coding system is less important than making sure everyone refers to the same version.

Iduoduo’s documented project-management process emphasizes that production should be based on final approved files and specifications rather than scattered chat records. Project information can include file version, dimensions, materials, colors, lighting, power, mounting, packaging, modification history, approval status, and delivery date.

Approval should also distinguish between visual approval and engineering approval.

A rendering can confirm:

  • logo proportion
  • layout
  • color direction
  • daytime appearance
  • illuminated appearance

An engineering drawing should confirm:

  • construction
  • depth
  • material thickness
  • mounting
  • wiring
  • power arrangement
  • hole positions
  • segmentation
  • installation interface

Those two approvals solve different problems.

A rendering can look perfect while hiding a mounting conflict. An engineering drawing can be structurally correct while using the wrong brand color. Both need attention before manufacturing begins.

A useful rule is:

No metal cutting, acrylic machining, painting, or LED assembly should begin until the production version is clearly approved.

For repeat orders, approval still matters. The shop should confirm whether the new order uses the same size, destination, voltage, mounting, packaging, and environment. Repeat production is faster when records exist, but it should not be treated as automatic cloning.

Is a Sample or First Article Necessary?

A sample or first article is most valuable when one mistake would be multiplied across many units.

For a one-off local storefront sign with a familiar construction, detailed drawings and production photos may be enough. For a 30-store rollout, a new logo design, an unusual finish, or a new mounting system, producing one approved unit before the full batch can prevent a much larger problem.

Iduoduo’s documented Channel Letter timing is:

Production TypeTypical Time
Standard sample or single unit5–7 days
Special-process sample7–15 days
Regular small batch7–10 days
Medium batch10–20 days
Large batchProject schedule required

Special-process samples may take longer when a project involves unusual finishes, complex structures, custom accessories, RGB or RGBW controls, special waterproofing, custom power supplies, or uncommon packaging requirements.

A first article should confirm more than appearance.

For channel letters, check:

  • overall dimensions
  • logo proportions
  • minimum strokes
  • return depth
  • face fit
  • surface finish
  • paint color
  • LED color or CCT
  • lighting uniformity
  • halo spread where applicable
  • power-supply arrangement
  • wire exits
  • mounting holes
  • stud positions
  • template accuracy
  • packaging
  • accessories

For a multi-location project, the approved first article can become the production reference.

Suppose a restaurant chain orders 60 sets of 900 mm-wide halo-lit logos. If the first set shows that the stand-off distance produces an uneven halo on the intended wall surface, correcting one sample is straightforward. Discovering the same problem after 60 sets are manufactured is very different.

The same logic applies to color.

If the return paint is slightly too warm or the face acrylic is not matching the brand standard closely enough, a first article gives the shop a chance to correct it before the full batch runs.

Iduoduo’s sample and first-article system is documented around confirming dimensions, proportion, materials, surface treatment, color, lighting, color temperature, wiring, power supply, mounting, and packaging before large-volume replication.

A sample is therefore not an extra step for every project. It is insurance for projects where repetition makes the cost of one mistake much larger.

How Are Production and Delivery Scheduled?

Production scheduling should begin from the required installation date and work backward.

A factory’s 7–10 day production time does not mean the sign shop can place an order ten days before installation. A real project also needs time for drawing approval, materials, testing, packaging, transportation, customs clearance, local delivery, inspection, and installation preparation.

Iduoduo’s documentation states that production lead time should be counted after important commercial and technical conditions are completed, including file confirmation, quotation approval, payment arrangements, material and color confirmation, production drawing approval, and special accessory confirmation.

A realistic project schedule can look like:

StageExample Allowance
Technical review and quotation1–3 days
Drawing revision and approval2–5 days
Sample, if required5–7 days
Regular production7–10 days
Pre-shipment testing72 hours
Packing and dispatch preparation1–3 days
Express transitAbout 12 days
Sea freight to USAAbout 30 days
Sea freight to EuropeAbout 50–60 days

The exact timing changes by project. Large quantities, special finishes, custom parts, complex electrical configurations, or multi-location packaging can extend production.

For a 40-store rollout, it may be better to split production and shipping into batches.

For example:

BatchQuantityPurpose
First article1 setFinal construction approval
Batch 110 setsEarliest opening locations
Batch 215 setsSecond installation wave
Batch 314 setsRemaining locations

Batching has several advantages.

It gives the installer earlier access to the first locations, reduces the risk of one late component holding the entire order, and allows feedback from early installations to be reviewed before the final units ship.

Packing should follow the same schedule.

If 40 stores receive identical-looking channel letters, cartons should be separated and identified by store, product, accessories, and carton number. A rollout can be manufactured correctly and still become difficult in the field if the wrong mounting template or power supply reaches the wrong location.

Iduoduo’s documented multi-store process supports first-store samples, first-batch production, staged inspection, store-specific packing, batch shipping, and later replenishment.

The most useful project schedule is therefore not “production finishes on September 10.”

It is:

approval date → production release → testing completion → packing date → shipment departure → expected arrival → local receiving → installation date.

How Should Changes Be Controlled After Approval?

Changes after approval should be treated as revisions, not casual messages.

A change that looks minor on screen can affect several production steps.

Changing letter height can affect:

  • metal length
  • acrylic size
  • LED quantity
  • power load
  • mounting spacing
  • packaging volume

Changing return depth can affect:

  • appearance
  • LED diffusion distance
  • halo effect
  • weight
  • material use
  • freight

Changing the wall condition can affect:

  • studs
  • holes
  • raceway
  • backboard
  • wire exits
  • stand-off distance

For every requested change, the factory should answer three questions:

  1. Has production already started?
  2. Which parts are affected?
  3. Does the change affect price or delivery?

A practical revision record can look like:

RevisionChangeProduction Impact
R1Overall width 2200 → 2400 mmRecalculate materials and LED
R2Return color silver → blackPaint specification changed
R3Wire exit rear center → lower rightBack and wiring changed
R4ApprovedReleased for production

Once production begins, changes can have very different consequences depending on the stage.

If metal has not been cut, a dimension change may be relatively simple.

If metal shells are already welded, the same change may require remanufacturing.

If painting is complete, a color change may require stripping, refinishing, or rebuilding.

If products are already packed, changing installation hardware may require reopening every carton.

A useful rule is to create a clear production freeze point.

Before the freeze:

  • artwork can be revised
  • dimensions can be corrected
  • colors can be adjusted
  • mounting can be updated
  • pricing and lead time can be recalculated

After the freeze:

  • every change is reviewed for cost
  • every change is reviewed for schedule impact
  • affected parts are identified
  • written approval is required before work continues

Version control is especially important when several people are involved. Sales, design, engineering, production, QC, and packaging should all receive the same updated file.

Iduoduo’s documented project-file system records file versions, specifications, modification history, approval status, and delivery requirements, reducing the risk of different departments following different instructions.

The most reliable outsourced projects are not the ones with the fewest changes. They are the ones where every change is visible, approved, traceable, and understood before the next manufacturing step begins.

Which Manufacturing Controls Reduce Project Risk?

Quality control and lighting inspection for custom LED channel letters before shipment

Manufacturing controls reduce channel letter risk by catching errors before installation. The most important controls are engineering review, approved production files, incoming-material checks, first-article inspection, in-process QC, dimensional verification, lighting and electrical testing, mounting checks, packaging inspection, and retained production records. Strong controls protect installation time, reduce rework, and make repeat orders easier to reproduce.

How Do You Evaluate Channel Letter Capability?

A good-looking sample does not prove that a factory can reliably manufacture channel letters for commercial projects. The more useful question is whether the factory controls the full chain from drawing review to final packing.

Channel letter production normally involves several connected processes:

  • Logo and font engineering
  • Metal cutting
  • Return bending
  • Welding
  • Grinding
  • Surface finishing
  • Acrylic face fabrication
  • LED module layout
  • Wiring
  • Power-supply matching
  • Waterproofing and drainage
  • Mounting-hole preparation
  • Raceway or backboard fabrication
  • Lighting inspection
  • Electrical testing
  • Packing

Iduoduo’s documented channel letter process treats the product as a combination of font engineering, metal returns, face and back construction, LED layout, power matching, wiring, weather protection, drainage, mounting preparation, testing, and packing rather than a simple metal shell with LEDs added later.

A sign shop evaluating a manufacturing partner should therefore ask for evidence at several stages, not only finished photographs.

Capability to VerifyWhat to Ask ForWhy It Matters
EngineeringShop drawing or production drawing examplesShows whether drawings are reviewed before fabrication
Metal fabricationCutting, bending, welding photos or videoConfirms actual fabrication capability
Acrylic workFace cutting and fitting processReduces poor fit and visible gaps
LED assemblyInternal LED layout photosHelps evaluate lighting consistency
Electrical workWiring and power-supply setupReduces field electrical problems
QCInspection records or test photosShows whether quality is checked systematically
PackingFinished packing photosReduces shipping damage and missing parts
Repeat productionFile-retention processImportant for future replacements and rollouts

Factory scale can help, but numbers should be connected to real production capability.

Iduoduo documents:

  • 5 production bases
  • 21,000 m² of manufacturing space
  • 500+ employees
  • 18 production lines
  • 10+ designers
  • 20+ engineers
  • 30+ QC personnel
  • approximately 15,000 units of regular monthly capacity

Those figures matter only when they translate into practical control. Five production bases should allow different processes and product categories to run without forcing every order through one small workshop. Engineering staff should be able to review structure, lighting, wiring, mounting, and packing. QC staff should inspect production rather than only checking cartons before shipment.

A useful factory evaluation should include questions such as:

  • Who reviews the drawing before production?
  • Who decides LED spacing and power-supply capacity?
  • Are mounting holes checked against the approved drawing?
  • Does QC inspect only finished signs or also work in progress?
  • Are failed products rechecked after repair?
  • Can test photos or videos be supplied?
  • Can order records be retrieved one or two years later?
  • Who handles a replacement if the problem is discovered after installation?

A factory that can answer those questions clearly is usually easier to work with than one that only responds with “no problem.”

What QC Checks Should Be Completed?

Channel letter QC should follow the same sequence as production. Waiting until the sign is completely assembled makes some errors expensive to correct.

A useful QC system has at least four stages:

  • Incoming material inspection
  • First-article or setup inspection
  • In-process inspection
  • Final inspection before packing

Iduoduo documents incoming inspection, first-article approval, in-process inspection, dimensional and appearance checks, 100% lighting inspection, electrical and functional verification, outdoor-protection review, packaging inspection, nonconforming-product control, reinspection after rework, and traceable release records.

For channel letters, the inspection list should cover more than appearance.

QC ItemTypical Risk if Missed
Overall dimensionsLetters do not fit elevation or sign band
Logo proportionsBrand appearance changes
Return depthLighting or visual depth differs from drawing
Face fitGaps, loose faces, uneven edges
Weld qualityCracks or poor appearance
Paint colorBrand inconsistency
Surface finishScratches, dents, grinding marks
LED placementHotspots and dark areas
CCT / LED colorDifferent letters appear mismatched
WiringIntermittent or failed illumination
Power supplyIncorrect load or destination-market mismatch
Stud positionsInstaller cannot use planned holes
Wire exitsCable appears in wrong location
Raceway dimensionsField installation conflict
HardwareMissing installation parts
PackingTransport damage or mixed components

Dimensional QC is particularly important when letters are part of an existing elevation.

A 5 mm difference on one isolated letter may not create a serious problem. A 5 mm positional error repeated across a 12-letter mounting pattern can become much more noticeable. Hole positions and spacing should therefore be checked against the approved drawing rather than measured only against the finished metal shell.

Color control also deserves more attention than many shops expect.

The factory should know whether the requirement is:

  • Pantone
  • CMYK reference
  • RGB reference
  • physical sample
  • approved paint sample
  • previously produced batch reference

Visual color matching from a phone screenshot is unreliable. Lighting conditions, displays, camera settings, and coatings can all shift appearance.

For repeat orders, the approved color reference should remain part of the project file.

Iduoduo’s documented QC scope covers materials, dimensions, quantity, fonts, logo proportions, colors, surface treatment, acrylic edges, welding, LED brightness, color temperature, lighting uniformity, dark areas, hotspots, power supplies, wiring, connectors, mounting holes, wire exits, accessories, packing, and outer-carton information.

The best QC question for a sign shop is simple:

What problems are being caught before they reach the installer?

How Should Lighting and Electrical Systems Be Tested?

Illuminated channel letters should be powered and inspected before packing. A sign can look perfect while unlit and still contain electrical problems that only appear after several hours of operation.

Lighting inspection should check:

  • Every letter illuminates
  • LED color is consistent
  • Color temperature is consistent
  • No visible dark areas
  • No strong hotspots
  • Corners receive sufficient light
  • Wide strokes remain evenly illuminated
  • Narrow strokes are not overly bright
  • Wiring connections remain secure
  • Power supplies operate normally
  • RGB or RGBW controls work correctly where used

Iduoduo documents 100% lighting inspection for illuminated products followed by a 72-hour pre-shipment test. The test is used to observe LED stability, power-supply stability, controller operation, flickering, early failures, color differences, local dark areas, abnormal temperature, and wiring connections. When a problem is found, the affected component is repaired or replaced and verified again.

The 72-hour period is especially useful because some electrical faults do not appear during a five-minute power-on test.

Typical early failures can include:

ProblemShort Power-On TestLonger Test
Dead LEDUsually visibleVisible
Loose connectionMay be missedMore likely to appear
Intermittent flickerMay be missedEasier to detect
Power-supply instabilityMay appear normalMore likely to surface
Abnormal heatHard to judgeEasier to observe
Color differenceUsually visibleVisible
Controller issueMay be intermittentEasier to identify

Lighting also needs to be judged according to construction.

Front-lit letters need even face illumination.

Halo-lit letters need balanced rear illumination, but final halo appearance also depends on:

  • Wall color
  • Wall texture
  • Stand-off distance
  • Letter depth
  • LED spacing
  • Ambient light
  • Viewing distance

A factory can control letter construction and LED layout, but it cannot guarantee exactly the same halo appearance on every wall surface.

Electrical configuration should also match the destination market and project requirements.

Before production, confirm:

  • Input voltage
  • Power-supply requirement
  • Power-supply location
  • LED voltage
  • Wiring groups
  • Cable length
  • Cable exit
  • Certification requirement
  • Controller type
  • Indoor or outdoor use

Iduoduo documents project-specific confirmation of voltage, power supply, certification, wiring, installation, and environmental conditions rather than assuming one electrical setup fits every market.

A sign shop should ask for test photos or videos before shipment when the project is large, unusual, or difficult to replace quickly.

The purpose is not to collect marketing material. It is to create a record showing that the letters were operating correctly before they entered international freight.

What Makes Channel Letters Install-Ready?

A channel letter is not truly finished when fabrication is complete. It is finished when the installation team can identify the parts, understand the mounting arrangement, connect the electrical system, and put the sign on the wall without rebuilding factory decisions on site.

Install-ready preparation can include:

  • Correct mounting holes
  • Correct stud positions
  • Mounting pattern or template
  • Wire exits in approved locations
  • Raceway or backboard when specified
  • Power supplies
  • Wiring identification
  • Required connectors
  • Installation hardware
  • Clearly separated accessories
  • Numbered letters
  • Carton labels
  • Installation reference drawing

Iduoduo’s documented manufacturing support for sign shops includes reserved mounting holes, wire exits, power supplies, raceways or backboards, installation templates, separated power-supply packing, neutral packing, and repeat-order support.

Mounting accuracy deserves particular attention.

Suppose a 14-letter storefront sign requires individual stud mounting. The installer expects to use a paper or rigid template. If several stud positions differ from the template by 10–15 mm, the crew may need to stop installation, remeasure the letters, and drill new holes.

On the factory floor, correcting a stud position may take minutes.

On site, the same error may involve:

  • Lift rental
  • Two installers
  • Drilling through finished cladding
  • Cable access
  • Additional sealant
  • Repainting or patching
  • Rescheduling electrical work

Installation cost can quickly exceed the manufacturing price difference between two suppliers.

Wire exits create a similar risk.

A drawing should indicate where power leaves each letter. If the installer has prepared electrical penetrations at the lower-right side but the factory places every cable in the center, the field team may need to extend wires or create new wall penetrations.

For large rollouts, identification is also part of install readiness.

A practical packing label might include:

Label FieldExample
ProjectRestaurant Rollout 2026
StoreStore 018
SignMain Elevation
ProductChannel Letter Set
Carton2 of 4
AccessoriesBox A
DrawingCL-018-R4

The goal is simple: the installation crew should not need to call the factory to find out which hardware belongs to which sign.

How Are Batch Consistency and Reorders Controlled?

Repeat orders become difficult when the original factory records only the finished appearance.

For channel letters, consistent reproduction requires more than saving the logo file.

Iduoduo documents retention of:

  • Final drawings
  • Fonts
  • Dimensions
  • Materials
  • Colors
  • Return depth
  • LED specifications
  • Power supplies
  • Mounting holes
  • Wire exits
  • Templates
  • Packing
  • QC records

Those records are especially important for chain stores, franchise programs, regional rollouts, and replacement letters.

Imagine a sign company orders 25 storefront sets in 2026 and another 8 locations are added in 2027.

If only the logo file is saved, the next production run still needs to rediscover:

  • return depth
  • paint formulation
  • acrylic type
  • LED color temperature
  • LED module model
  • module spacing
  • power-supply model
  • stud positions
  • wire exit
  • mounting template
  • packaging method

If those details are stored, the new order starts much closer to the original approved standard.

Batch consistency should be monitored across the production run as well.

Important repeatable variables include:

VariableWhy It Should Be Recorded
MaterialDifferent thickness or grade affects structure
Paint / finishControls visual consistency
AcrylicChanges diffusion and face appearance
Return depthAffects appearance and lighting
LED modelAffects brightness and color
LED spacingAffects hotspots and dark areas
Power supplyAffects electrical performance
Mounting patternKeeps installation consistent
Wire exitPrevents site changes
Packing methodKeeps rollout handling consistent

A saved specification is not a reason to skip confirmation on the next order.

Iduoduo’s documentation states that repeat production still needs to confirm destination country, voltage, quantity, and installation environment.

Component availability can also change. A specific LED or power-supply model used two years earlier may no longer be available. A material supplier may change. A paint batch can vary. The correct approach is to compare the new production conditions with the stored standard and approve any substitution before manufacturing.

For replacement letters, records become even more valuable.

If one letter in a 20-letter sign needs replacement, the shop should not have to send the entire sign back for measurement. The factory should be able to retrieve the approved dimension, return depth, finish, lighting configuration, mounting details, and wiring information for the specific letter.

Iduoduo documents order-file retention for approximately 2–3 years to support after-sales analysis and repeat production.

Manufacturing control therefore continues after the first shipment.

A reliable channel letter program should create a record that allows the next batch, replacement part, or new location to begin from known specifications instead of rebuilding the project from memory.

How Can Sign Shops Protect Margin and Customer Relationships?

Neutral packaging for wholesale channel letters protecting sign shop customer relationships

Sign shops protect margin by calculating the full installed cost—not just the factory price—and by setting clear rules for confidentiality, neutral packaging, shipping, warranty, and repeat orders. The manufacturing partner should remain behind the sign shop, while the sign shop keeps control of quotations, approvals, installation, account communication, and future work. Clear boundaries reduce price leakage, site surprises, and the risk of losing long-term accounts.

How Should Outsourcing Costs Be Calculated?

A factory quotation is only one line in the real project cost.

A sign shop may receive two quotations for the same channel letter set:

  • Factory A: $1,850
  • Factory B: $2,100

At first glance, Factory A looks $250 cheaper.

But if Factory A does not include mounting templates, requires extra local wiring work, ships in weak packaging, and produces one letter with an incorrect wire exit, the lower purchase price can disappear quickly.

A more useful calculation is based on the total installed cost.

Cost AreaWhat Should Be Included
ManufacturingLetters, raceway, backboard, power supplies, hardware
EngineeringDrawing revisions, structure changes, samples
PackagingReinforced cartons, foam, crates where required
FreightExpress, air, sea, local delivery
Import CostDuty, brokerage, handling where applicable
ReceivingUnloading, inspection, temporary storage
InstallationCrew, lift, wiring, drilling, sealant
ReworkRepairs, remanufacturing, replacement freight
Project ManagementDrawing approval, communication, scheduling
ContingencySite changes and unexpected costs
Gross MarginRequired profit after all project costs

For example, compare two hypothetical suppliers:

Cost ItemSupplier ASupplier B
Factory Price$1,850$2,100
Freight$420$390
Mounting Template$80Included
Extra Wiring Work$180$0
Site Rework$350$0
Total Cost$2,880$2,490

Supplier B appears 13.5% more expensive at the factory level but ends up about $390 cheaper after installation.

That is why a purchasing decision based only on EXW or FOB price can be misleading.

Sign shops should also calculate the value of internal production capacity.

Suppose a shop can fabricate ten channel letter sets internally and save $150 per set compared with outsourcing.

The apparent saving is:

10 × $150 = $1,500.

However, if those ten sets occupy fabrication equipment and skilled staff for one full week, and the shop has to reject two other projects worth $2,500 in gross profit, the real result changes.

The shop technically saved $1,500 in manufacturing but lost more than that in capacity.

A better margin calculation asks:

  • What is the landed manufacturing cost?
  • What local labor will still be needed?
  • What is the expected installation time?
  • What is the cost of a second site visit if something is wrong?
  • How much internal capacity does the project consume?
  • What other work could be completed during the same period?
  • How much contingency should be reserved?
  • What gross margin remains after every project cost?

Freight deserves particular attention for international sourcing.

Channel letters are relatively light compared with some solid metal products, but their cartons can occupy substantial volume. Large letters, raceways, backboards, and protective packaging increase dimensional weight and sea-freight volume.

For that reason, a quotation should ideally identify whether freight is:

  • included
  • estimated separately
  • based on express
  • based on air
  • based on sea freight
  • door-to-door
  • port-to-port
  • subject to final packing dimensions

Iduoduo’s documented reference transit times are about 12 days for express, about 30 days by sea to the United States, and around 50–60 days by sea to Europe, although actual transit depends on vessel schedules, customs, seasonality, weather, and local delivery.

Margin should therefore be reviewed before the selling price is finalized, not after the order has already been accepted.

A healthy outsourced channel letter project is not the project with the cheapest factory invoice.

It is the project where the sign shop knows the expected gross profit before production begins and where manufacturing, freight, receiving, installation, and service costs remain within the planned range.

Do Neutral Packaging and Confidentiality Matter?

For sign shops, confidentiality is part of supplier reliability.

An outside factory may receive:

  • End-account logos
  • Store addresses
  • Brand guidelines
  • Drawings
  • Rollout schedules
  • Quantities
  • Installation information
  • Contact names
  • Internal project numbers
  • Packaging instructions
  • Future expansion plans

That information can be commercially sensitive.

The manufacturing partner should therefore understand that the sign shop owns the commercial relationship.

Iduoduo’s documented cooperation model for sign companies specifically includes information confidentiality, customer-resource protection, neutral communication, neutral packaging, file clarity, stable pricing, controllable lead times, and timely problem reporting. The company is positioned as a manufacturing backend rather than an organization that bypasses the sign company and manages its end account directly.

Neutral packaging is one practical part of that arrangement.

Depending on the project, neutral packaging may mean:

  • No factory advertising on visible packaging
  • No promotional brochures inside the carton
  • No unrelated factory catalogs
  • No factory-branded installation sheet unless approved
  • Project number instead of end-account name where practical
  • Sign shop labeling where requested
  • Store identification without unnecessary commercial information
  • Power supplies and accessories packed without promotional material

For a local installer receiving goods directly from an overseas factory, carton markings still need enough information to identify the shipment.

A practical balance could look like:

InformationUsually NeededUsually Avoided
Project NumberYes—
Store NumberYes—
Carton NumberYes—
Product TypeYes—
Installation AreaOften useful—
Sign Shop NameIf requested—
Factory Marketing Material—Avoid
Sales Promotion—Avoid
Factory Retail Contact—Avoid

Confidentiality also applies during communication.

If the factory receives the delivery contact for a shopping mall, restaurant, hotel, or chain store, the purpose may only be to coordinate receiving. That contact should not automatically become a sales lead.

A sign shop should establish clear rules before the first direct shipment:

  • Who can communicate with the receiving contact?
  • What topics may be discussed?
  • Should the sign shop be copied on messages?
  • Can the factory discuss only logistics?
  • Who handles product questions?
  • Who handles future quotations?
  • Who receives warranty claims?
  • Should all commercial questions return to the sign shop?

For recurring programs, these boundaries become even more important.

A sign shop may spend years building a relationship with a regional restaurant group or franchise operator. The manufacturing partner’s value comes from making production easier, not inserting itself between the shop and the account.

Neutral cooperation therefore protects more than one order.

It protects future storefront replacements, new locations, rebrands, repairs, and expansion projects.

Can a Factory Ship Without Contacting the End Customer?

Yes. A factory can ship directly to a job site, installer, warehouse, or store while keeping commercial communication under the sign shop’s control.

The arrangement works best when shipping instructions are confirmed before packing.

The sign shop should provide:

  • Consignee name
  • Delivery address
  • Phone number required by the carrier
  • Receiving hours
  • Loading-dock information
  • Lift-gate requirement where applicable
  • Store or project number
  • Carton-labeling rules
  • Required arrival window
  • Sign shop contact for commercial questions
  • Instructions on whether direct communication is permitted

Direct-to-site shipping can be useful for large channel letter projects because sending the goods to the sign shop first may add an extra freight leg.

For example:

Factory → Sign Shop → Job Site

may become:

Factory → Job Site.

Removing one transfer can reduce:

  • Local freight
  • Warehouse handling
  • Double loading
  • Double unloading
  • Risk of scratching finished surfaces
  • Time spent repacking products

Direct delivery is particularly useful for large raceways, oversized letters, or multi-store rollout programs where each location receives its own set.

However, direct shipping is not always the best option.

Shipping to the sign shop first may make more sense when:

  • A receiving inspection is required
  • Hardware needs to be added locally
  • Electrical components will be changed locally
  • The installation crew wants to stage the job
  • Several products from different suppliers must be combined
  • The site has limited receiving space
  • Installation dates are not fixed
  • The sign shop does not want the site contact communicating with the factory

For multi-location projects, packing accuracy becomes just as important as product accuracy.

Consider a 25-store rollout.

Each location may have:

  • 1 channel letter set
  • 2 power supplies
  • 1 mounting template
  • 1 hardware kit
  • 1 wiring diagram
  • 1 project drawing

If the factory produces all 25 sets correctly but mixes five hardware kits and three templates, installation problems still occur.

Store-by-store packing should therefore follow a controlled identification system.

Label FieldExample
ProjectCoffee Rollout 2026
StoreStore 027
CityDenver
ProductMain Channel Letters
Carton1 of 3
Accessory BoxA
Drawing RevisionR5

Iduoduo’s documented production system supports store-specific packaging, carton identification, separated accessories, and batch shipment for multi-location projects.

Direct shipping should also preserve neutral communication.

A carrier may need a local phone number. A factory logistics coordinator may need to confirm delivery hours. Those operational contacts do not need to become commercial conversations.

The simplest rule is:

The factory manages the shipment. The sign shop manages the account.

How Should Warranty and After-Sales Support Work?

A useful warranty process should start with diagnosis rather than blame.

When a channel letter fails after installation, the visible symptom may be simple:

“Letter R is not lighting.”

The actual cause could be:

  • LED module failure
  • Loose connector
  • Damaged wire
  • Power-supply failure
  • Wrong input voltage
  • Water ingress
  • Installation damage
  • Freight damage
  • Controller problem
  • On-site electrical problem

A factory that automatically sends a replacement without understanding the failure may solve the immediate complaint but learn nothing from the problem.

A better process uses evidence.

The sign shop can provide:

  • Overall installation photo
  • Close-up photo of the failed letter
  • Video showing the lighting problem
  • Power-supply label photo
  • Voltage reading when available
  • Wiring photo
  • Connector photo
  • Date the problem began
  • Whether the failure is constant or intermittent
  • Whether other letters on the same power supply work normally

A simple diagnostic flow may look like:

SymptomFirst Checks
One letter completely darkConnection, wiring, LED modules
Several letters darkPower supply, circuit, input voltage
Letter flickersConnection, power supply, LED fault
Different colorLED batch, module issue, control setting
Local dark areaIndividual LED module or connection
Water visibleSeal, drainage, cable entry, installation
Sign works intermittentlyWiring, connector, power supply

Iduoduo’s documented after-sales process states that, after receiving photos or videos, the company typically responds within 24 hours, performs an initial cause assessment within 24–48 hours, can arrange small replacement parts within approximately 3–7 days, and aims to provide a solution for major issues within 48–72 hours.

The documented warranty position is:

72-Hour Pre-Shipment Testing + 3-Year Warranty.

For illuminated products, Iduoduo records 100% lighting inspection followed by a 72-hour pre-shipment test intended to identify issues such as LED instability, power-supply problems, flicker, early failure, color differences, dark areas, abnormal heat, and wiring faults before shipment.

Warranty terms should still distinguish between manufacturing problems and field conditions.

A practical warranty review may consider:

  • Product type
  • Installation environment
  • LED
  • Power supply
  • Controller
  • Wiring
  • Voltage
  • Water ingress
  • Installation condition
  • Physical damage
  • Maintenance
  • Time in service

The goal is not to argue over responsibility.

The goal is to identify the fastest realistic fix.

For an installed sign, replacing a $15 electrical component can be much cheaper than shipping an entire letter across the world. Good after-sales support should therefore consider whether the repair requires:

  • Replacement LED modules
  • Replacement power supply
  • New controller
  • Wiring component
  • New acrylic face
  • Replacement letter
  • Remote troubleshooting
  • Installation adjustment

A sign shop should understand the supplier’s warranty procedure before placing recurring orders.

Ask:

  • What evidence is required?
  • Who determines the failure cause?
  • Are replacement parts available?
  • Who pays freight under different circumstances?
  • How quickly can parts be produced?
  • Are original drawings retained?
  • Can remote troubleshooting be provided?
  • How are recurring failures investigated?

After-sales support protects margin because every unresolved problem consumes staff time, installation labor, and account goodwill.

How Do Saved Production Files Simplify Reorders?

The first order is usually the most expensive order to engineer.

A repeat order should not require rebuilding the entire project from the beginning.

For channel letters, saving only the logo is not enough.

Iduoduo documents retention of repeat-production information including:

  • Final drawings
  • Fonts
  • Dimensions
  • Materials
  • Colors
  • Return depth
  • LED specifications
  • Power supplies
  • Mounting holes
  • Wire exits
  • Templates
  • Packaging
  • QC records

The value becomes obvious during real repeat orders.

Imagine a sign shop supplies a 14-location restaurant chain.

The first location requires several decisions:

  • 1,600 mm overall logo width
  • 90 mm returns
  • Black painted aluminum
  • White acrylic faces
  • 6500K LEDs
  • Individual stud mounting
  • Rear-center wire exits
  • Remote power supplies
  • Specific mounting template
  • Three-carton packing method

Six months later, the restaurant group adds five stores.

Without records, the shop may need to search old email threads and ask:

  • Which return depth did we use?
  • Was the face 3 mm or 5 mm acrylic?
  • Which white LED did we approve?
  • Where were the cable exits?
  • Which power supply was used?
  • Which paint reference matched the first batch?
  • Do we still have the mounting template?

With a controlled production file, the repeat order starts from the approved standard.

The shop then only needs to confirm what has changed.

Repeat-Order ItemUsually ReusedNeeds Reconfirmation
Logo geometryYesIf branding changed
Return depthYesIf size changes significantly
MaterialsYesAvailability should be checked
FinishYesBatch matching should be reviewed
LED specificationUsuallyModel availability should be checked
Power supplyUsuallyDestination and voltage must be checked
Mounting patternOftenSite conditions must be confirmed
PackagingOftenQuantity and destination may change
QuantityNoConfirm every order
Delivery dateNoConfirm every order

Iduoduo also documents order-file retention for approximately 2–3 years to support after-sales work and repeat production.

Saved files are especially useful for replacement letters.

Suppose one letter is damaged two years after installation.

If the production record contains the original:

  • dimension
  • return depth
  • finish
  • acrylic
  • LED configuration
  • wire exit
  • mounting details

the replacement can be evaluated against known data rather than starting from photographs and rough measurements.

For sign shops managing chain programs, file retention also reduces administrative work.

The commercial value can extend far beyond faster quotation.

A reliable repeat-production record can help a sign shop:

  • Quote new locations faster
  • Reduce engineering time
  • Reduce specification errors
  • Standardize installation
  • Replace damaged letters more easily
  • Maintain brand consistency
  • Handle expansion without rebuilding specifications
  • Keep long-term accounts easier to service

Repeat-order files should not be treated as permission to copy everything blindly. Materials and electronic components can change over time, and new locations can have different voltage, walls, environments, or installation conditions.

The best repeat process is therefore:

Reuse the approved standard, identify what changed, confirm the changed variables, and release a new controlled production version.

That approach protects both margin and the relationship. The sign shop spends less time rebuilding old projects, installers receive more consistent products, and the end account experiences a smoother expansion or replacement process.

Discuss Your Channel Letter Project With Iduoduo

If your sign shop is considering outsourcing a channel letter project, the easiest starting point is to send the available artwork, dimensions, quantity, lighting type, mounting requirements, destination, and target delivery date. Iduoduo can review the project for manufacturability, identify missing specifications, and confirm whether the proposed construction is suitable before production begins.

For projects involving samples, repeat orders, complex logos, multi-location rollouts, or temporary capacity gaps, Iduoduo can support engineering review, OEM manufacturing, QC, testing, export packing, and international delivery. The aim is to make the production side easier to manage while your team keeps control of project communication, approvals, installation, and the relationship with the end account.

If you have an upcoming channel letter project, send the drawings or project details to Iduoduo for quotation and technical review. A clear specification usually makes it much easier to compare options, estimate lead time, and decide whether outsourcing is the right production route for the job.
